Cycle Time Reduction: Boost Efficiency with Proven Strategies Preventable maintenance problems alone cost U.S. discrete manufacturers an estimated $119.1 billion in losses — including $18.1 billion from downtime and $100.2 billion from delays and defects. That figure doesn't account for idle machines, changeover delays, or the capacity that looks fine on paper but never shows up in actual output.

The real problem isn't any single failure. Cycle time erodes through dozens of small inefficiencies that compound quietly across every shift: a 30-second delay per part, multiplied across hundreds of parts, can erase an entire production run's worth of output. By the time a missed delivery deadline makes the problem visible, the losses have already accumulated for days or weeks.

This article breaks down where those losses originate — bottlenecks, changeover waste, unplanned downtime, workforce idle time, and visibility gaps — and what manufacturers can do about each one.


Key Takeaways

  • Cycle time losses accumulate gradually through small inefficiencies, not single visible failures
  • Bottlenecks, changeover time, unplanned downtime, and operator idle time are the primary drivers
  • Reduction requires three coordinated interventions: smarter decisions, tighter in-process control, and stronger surrounding systems
  • Real-time monitoring catches deviations while they're still correctable — not after the shift ends
  • Continuous measurement of actual vs. standard cycle times is what separates sustained gains from one-time fixes

How Cycle Time Losses Accumulate in Manufacturing

Most cycle time problems don't announce themselves. They build through ordinary-looking events: an operator waiting for job instructions, a machine idle between operations, a workaround that adds two minutes to every setup.

That accumulation is what makes the math so damaging. A 30-second delay per part seems negligible — but across 400 parts in a shift, that's over three hours of lost production, an entire additional production run that never happened.

Because these losses occur inside the normal flow of work, they rarely trigger an alarm until a delivery deadline is missed or OEE data finally gets reviewed.

Visible vs. Hidden Losses

Not all cycle time losses are equally easy to find:

Visible losses (easier to track and plan around):

  • Scheduled changeovers
  • Planned maintenance windows
  • Known quality inspection holds

Hidden losses (invisible until scale or stress exposes them):

  • Operator wait time between jobs
  • Informal workarounds that add undocumented steps
  • Rework performed outside the standard process
  • Time spent locating tooling, instructions, or job travelers

The hidden category is where most manufacturers have the most untapped opportunity. Coastal Machine and Supply discovered this firsthand — after implementing machine monitoring on a five-axis system, they identified losses in setup duration, part-change downtime, and unattended machine stops that had been invisible before. The result: a 46% relative increase in utilization on that machine.

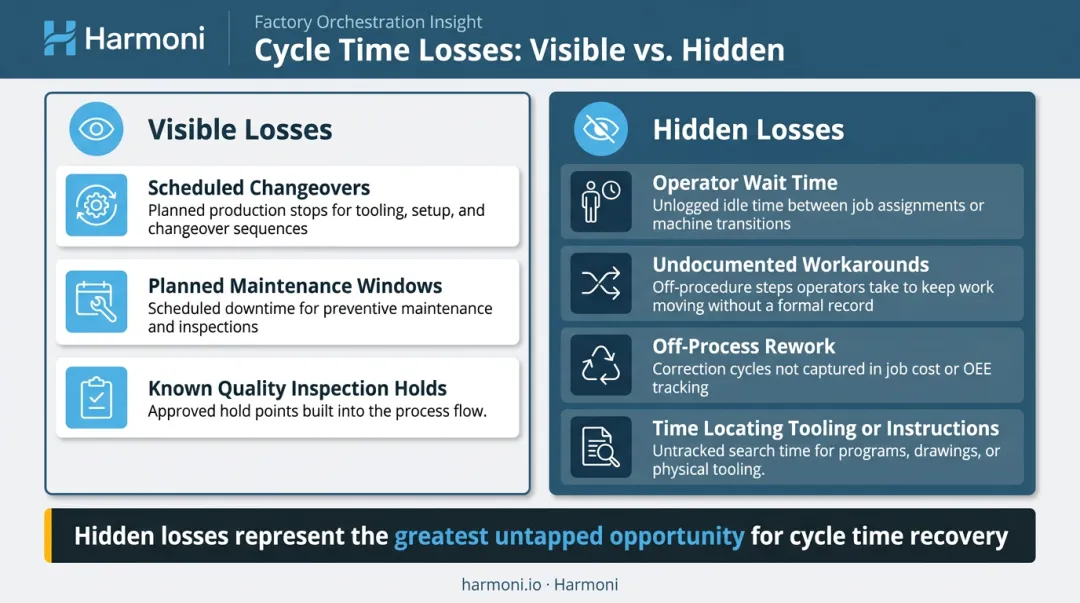

Visible versus hidden manufacturing cycle time losses comparison infographic

Without measurement, those losses had no way to surface — which is precisely why visibility is the first step toward recovery.


Key Drivers of Extended Cycle Time

Bottlenecks

A bottleneck doesn't just slow down one workstation — it caps throughput for the entire production flow. The critical distinction is between the busiest station and the true constraint. These are often not the same. Scheduling around the wrong station leaves the real bottleneck unchallenged.

Stainless Works identified welding as its primary constraint, then corrected ERP routings and work center configurations to schedule against real capacity. Lead time dropped from 12–14 weeks to 5 weeks. No new equipment. No additional headcount. Just accurate constraint identification followed by aligned scheduling.

Changeover Time

In job shops and mixed-production environments, changeovers consume a disproportionate share of available production time — especially when setup steps are undocumented or inconsistent between operators.

A SMED study at ORS Bearings reduced total turning-line setup work from 1,418 to 930 minutes — a 34.42% reduction — by separating internal steps (requiring machine stoppage) from external steps (preparable while the machine runs). Elapsed setup time fell from 749 to 466 minutes after two-operator coordination was introduced. A recovered shift's worth of capacity, per changeover cycle.

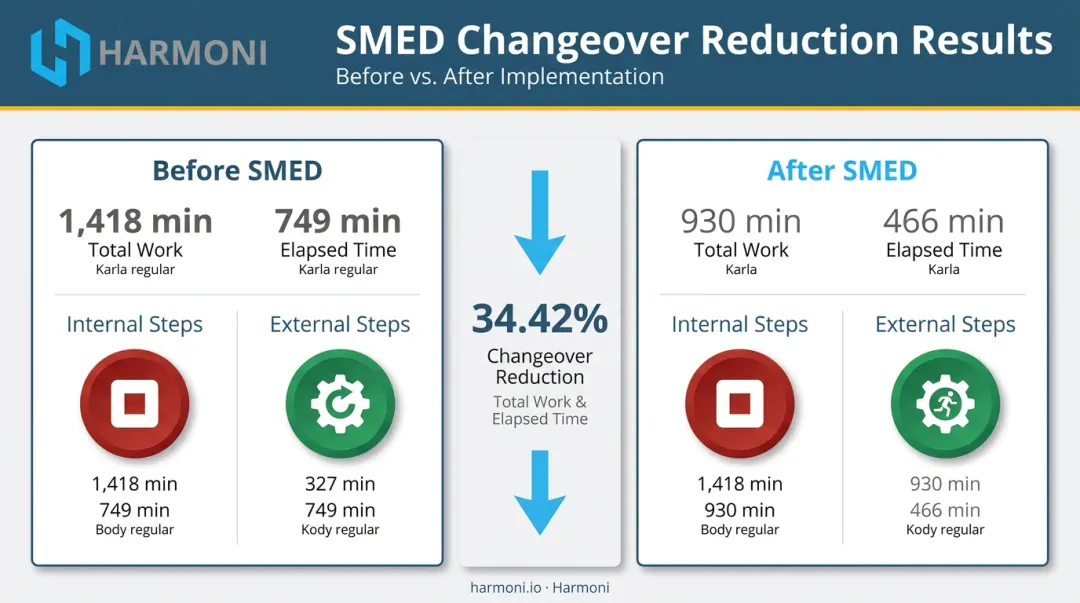

SMED changeover time reduction from 1418 to 930 minutes process improvement infographic

Unplanned Downtime

Unplanned downtime is uniquely costly because it's unpredictable. When a machine fails mid-run, the damage isn't just the stopped machine — it's the cascading delays across every downstream operation waiting on it.

NIST research found that plants in the highest quartile for reactive maintenance reliance experienced 3.3 times more downtime and 16 times more defects than plants in the lowest quartile. Maintenance strategy is a direct cycle time variable — not a background consideration.

Workforce Idle Time

Machine data alone doesn't capture the full picture. Operator idle time — caused by missing job instructions, unclear priorities, or delayed work order releases — adds non-machining time to every job without appearing in equipment utilization reports.

This category frequently goes untracked because it doesn't show up on a spindle utilization dashboard. But when an operator spends 12 minutes locating a setup sheet that should have been at the machine, that's 12 minutes of cycle time inflation that no machine monitoring system will flag.

Poor Process Visibility

When supervisors don't know where cycle time is being lost until after a shift ends, they lose the ability to intervene while the problem is still correctable. Knowing production is behind at 4 PM is categorically different from knowing a bottleneck emerged at 10 AM with six hours still available to respond.

Closing that gap requires live data, not shift-end summaries. Harmoni's factory orchestration platform combines real-time machine data, OEE monitoring, and andon-style visual indicators to surface deviations as they happen. Supervisors and planners get a current view of shop floor conditions — actionable while there's still time to respond.


Cycle Time Reduction Strategies

Effective strategies fall into three categories: decisions made before or around production, controls applied while production is active, and changes to the broader systems and environment surrounding the shop floor.

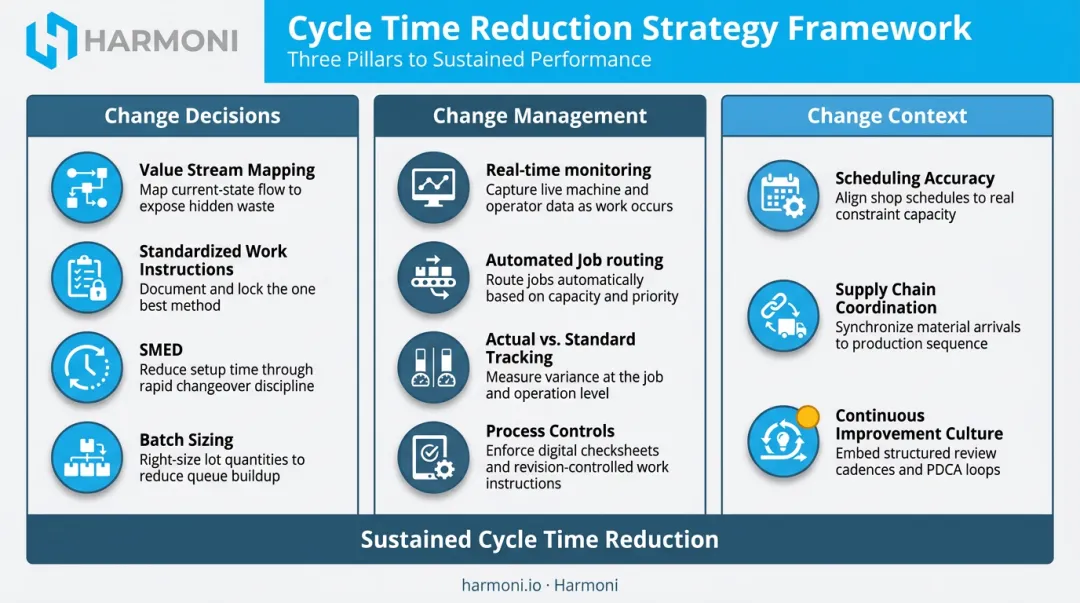

Three-category cycle time reduction strategy framework process flow infographic

Strategies That Change Decisions

Value stream mapping exposes every step in the production process — including waiting, unnecessary movement, and redundant inspection. Eliminating or resequencing non-value-adding steps before they become habitual is far cheaper than managing them reactively.

Standardizing work instructions and setup procedures at the job level removes operator-to-operator variability. Two operators performing the same setup differently isn't just a quality risk — it's a cycle time risk. When one operator takes 25 minutes and another takes 40 for identical work, the 15-minute gap shows up across every part that operator touches.

SMED (Single-Minute Exchange of Die) is a planning decision, not just a shop floor habit. Redesigning changeover sequences to move preparable steps outside machine-stop time requires deliberate process analysis — and the recoverable time is often larger than shops expect.

Batch sizing and job sequencing affect how long individual units wait between operations. Oversized batches increase WIP and extend effective cycle time even when machining time per part is fully optimized.

Strategies That Change How Cycle Time Is Managed

Real-time monitoring of machine activity and operator behavior is the most direct way to catch deviations while they're still correctable. The difference between a 10 AM alert and a 4 PM report isn't cosmetic — it's the difference between a correctable problem and a missed shipment.

Automating job routing, work order delivery, and operator task sequencing eliminates idle time caused by manual job lookup, priority clarification, and supervisor assignment. Harmoni's platform addresses this directly — using long-range RFID to identify the operator and job at each workcenter, automatically loading the correct CNC program, settings, and offsets, and surfacing work instructions on demand.

Operators know what to run next without waiting or guessing.

Tracking actual vs. standard cycle times at the part, program, and operator level — rather than averaging across the shift — allows planners to pinpoint exactly where time is being lost and whether the cause is a process issue, a tooling issue, or a training gap.

Enforcing process controls at the workcenter through guided checklists and structured step sequences prevents the small mistakes that trigger rework. In precision machining, a single out-of-sequence operation can require hours of correction. Preventing it costs seconds.

Strategies That Change the Context Around Cycle Time

Scheduling based on actual machine availability rather than theoretical capacity removes a structural source of idle time. When jobs are released to the floor before required machines or tooling are ready, operators wait — and that wait time inflates cycle time in ways that are difficult to attribute and easy to overlook.

Upstream supply chain coordination ensures materials, tooling, and components arrive when needed. Early delivery creates congestion; late delivery creates stoppages. Either way, the floor absorbs the cost.

Building a continuous improvement culture keeps initial gains from quietly reversing. Structured events like Kaizen reviews or regular floor walkthroughs give operators and supervisors a channel to surface observations about inefficiency — before new bottlenecks re-inflate cycle times after initial improvements are made.


Conclusion

Sustained cycle time reduction comes from identifying where time is actually being lost — in process design decisions, real-time execution gaps, or the systems surrounding the shop floor — and applying targeted interventions at each layer. Pushing machines harder or ratcheting up production pressure rarely moves the needle.

The manufacturers who sustain these gains share a consistent approach: they measure actual performance against standard on an ongoing basis, close the feedback loop between the floor and planning, and treat every deviation as useful data rather than noise to dismiss. One-time projects create temporary improvements. Continuous measurement — with real consequences when numbers drift — is what makes them stick.


Frequently Asked Questions

What does cycle time reduction mean?

Cycle time reduction is the intentional shortening of the total time required to produce one unit from start to finish. It applies across machining time, wait time, changeover, and all other steps in the production sequence — not just spindle-on time.

How do you reduce cycle time?

Three levers drive most cycle time improvements:

  • Process decisions: standardization, SMED, value stream mapping
  • In-process management: real-time monitoring, automated job routing, actual vs. standard tracking
  • Surrounding systems: scheduling accuracy, supply coordination, continuous improvement culture

Is higher or lower cycle time better?

Lower cycle time is generally better — more units can be produced in the same period. However, cycle time must be balanced against takt time. Producing faster than customer demand requires creates overproduction waste, which creates its own operational costs.

What is the difference between cycle time, takt time, and lead time?

Cycle time is how long it takes to produce one unit. Takt time is the rate at which units must be produced to meet customer demand. Lead time is the total elapsed time from order receipt to delivery — including queue time, processing, and shipping.

What are the biggest causes of long cycle times in manufacturing?

The most common causes: production bottlenecks, unplanned downtime, excessive changeover time, operator idle time from missing instructions or unclear job priorities, and lack of real-time visibility into where production is deviating from standard.

How does real-time monitoring help reduce cycle time?

Real-time monitoring lets supervisors detect deviations as they happen rather than after the shift — enabling faster intervention. Pairing machine data with operator activity data pinpoints whether a delay is equipment-related, process-related, or a workforce coordination issue.
